Contract Manufacturing in Ukraine: Outsource or Own Capacity

Contract manufacturing model for foreign brands and manufacturers producing in Ukraine

Contract Manufacturing in Ukraine: What a Third-Party Producer Can and Cannot Carry

The national numbers describe a commodity exporter, which is why they are the wrong place to look

Ukraine's trade profile does not obviously support an outsourced-production thesis. The EU accounted for around 65% of Ukraine's goods trade in 2025 and imported €21.7 billion of Ukrainian goods, led by fats and oils, cereals, iron and steel, oil seeds and ores. That is a raw-materials profile, and it says nothing about whether a plant in Lviv or Vinnytsia can build a European company's product, to its drawing, repeatably.

Three things have changed since 2021. The upgraded Deep and Comprehensive Free Trade Area entered into force on 29 October 2025, giving the relationship a permanent legal framework and committing both sides to align production standards. Manufacturing has been redistributed westwards, with 725 enterprises leaving areas of active hostilities under the state relocation programme by August 2022 and 528 restarting, processing industry accounting for around 30% of them and Lviv, Zakarpattia and Chernivtsi absorbing the largest share. Output has also flattened rather than recovered, falling 2.4% in 2025 after 3.6% growth in 2024 and running 0.2% below the prior year in the first half of 2026, with manufacturing down 2.1%.

A flat national index conceals idle plants and fully committed ones in equal measure. Once the case for producing in Ukraine at all is settled, the question is whether a given producer's capability converts into output meeting the buyer's specification, quality regime and continuity expectations, and whether that is preferable to owning the plant.

Usable capability is firm-specific, and it is visible in three places

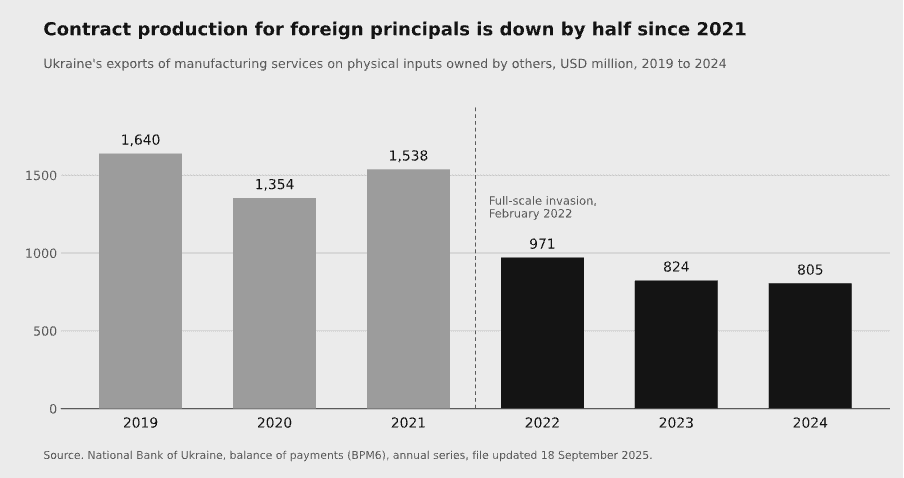

Where third-party production demonstrably works in Ukraine it works at company level rather than sector level, which is why sector-level rankings are of little use to a buyer. Light industry is the oldest case. Garment plants have operated for years on tolling arrangements, taking fabric from European principals and returning finished garments. Much of that capacity was reoriented after 2022 towards military, medical and tactical clothing, a reminder that installed sewing capacity is not capacity available to a new civilian customer.

Private-label consumer manufacturing is the newest. AFINA Group completed the privatisation of Vinnytsiapobuthim, an older household-chemicals plant, in January 2026 and launched contract manufacturing in July 2026 with the discount chain Kopiyochka as its first private-label customer. Biosphere, a household and hygiene manufacturer with established private-label activity and plants in Ukraine, Romania and Estonia, is the longer-established comparator. Both illustrate the same caveat. New capacity is being commissioned around domestic retail demand, so an incoming foreign brand joins an order book that is already forming.

Engineered production is the most fragmented. Ukrainian machining businesses market build-to-print work through the European Commission's Enterprise Europe Network, offering parts made to customer design and polymer components, while electronics assemblers advertise certified ISO 9001 systems and IPC-A-610 class 3 acceptance criteria. These are individual company offers, not evidence of a qualified national tier.

Outsourcing buys optionality and pays for it in control

The reason to commission production rather than build it is rarely the unit price. It is that a purchase order is reversible and a factory is not. Where volumes are unproven, where the product may still be redesigned, or where the board will not place irreversible capital in a country at war, outsourcing converts a country commitment into a commercial one and buys access to machinery and process knowledge that would be slow to replicate. What is surrendered is less visible at signature. The buyer loses direct control of process and scheduling, loses first claim on capacity when the plant is busy, cannot see the conversion cost behind the quoted price, and stops accumulating manufacturing knowledge of its own. Those losses are tolerable while volumes are small and the product is stable, and they compound as both change.

Contract Manufacturing vs Owned Production


Decision dimension

Contract manufacturing

Owned production

Capital commitment

Working capital, tooling and qualification only

Full capex, site, equipment and commissioning

Time to first output

Weeks to months, subject to qualification

Typically 12–24 months or longer

Minimum economic volume

Set by the supplier's minimum run and changeover cost

Set by the buyer's own fixed-cost recovery

Fixed-cost exposure

Largely variable, absorbed in unit price

Fixed, borne at any utilisation level

Process control

Indirect, through specification and control plan

Direct

Quality control

Exercised at distance through audit, approval and inspection

Exercised in line, continuously

Capacity and scheduling priority

Negotiated, competes with the supplier's other customers

Owned

Tooling and know-how

Portable only if contracted and documented for portability

Retained by default

Cost transparency

Limited to the quoted price

Full visibility of the cost stack

Reversibility

High, and this is the central commercial argument

Low

A plant that can make the product is not yet a supplier that can satisfy the buyer's customers

The distinction that decides most of these projects is between physical capability and commercially usable capability. A producer that can make an acceptable sample has demonstrated very little. What matters is repeatability under the buyer's acceptance criteria, together with the evidence the buyer's own customers and regulators require.

Much of that burden sits with the buyer. Under EU product rules an operator who markets a product under its own name or trademark takes on the manufacturer's obligations, including conformity assessment, the technical file and the declaration of conformity. An own-brand buyer cannot rely on the producer's certificates and needs verifiable inputs to a file it signs itself. That is also why the pending Agreement on Conformity Assessment and Acceptance of Industrial Products matters less to own-brand outsourcing than is usually assumed, since it is designed for Ukrainian producers selling under their own names. Legal implementation belongs with qualified counsel.

Two further constraints are current rather than theoretical. In consumer categories the gate is normally a retailer scheme such as IFS or BRCGS with batch traceability and factory audits, granted to a site rather than to a company. In metal-intensive categories the EU Carbon Border Adjustment Mechanism entered its definitive phase on 1 January 2026, so the importing buyer carries a certificate cost that depends on verified emissions data from its producer, with default values marked up by 10% in 2026 and 20% in 2027 where verification is missing. The German Economic Team estimatescumulative losses of around USD 1.4 billion in Ukrainian exports of covered goods to the EU across 2026 and 2027, most of it in iron and steel. Unit cost is now partly a function of the supplier's data discipline.

Installed capacity is not available capacity, and labour is the binding constraint

Available machinery is a weak proxy for available capacity. In the National Bank of Ukraine's fourth-quarter 2025 survey, companies named hostilities as the main limit on raising output, alongside high energy prices, limited production capacity and a shortage of skilled labour. Sentiment has since improved, with the business activity expectations index reaching 107.0 in the second quarter of 2026, though headcount expectations turned more cautious.

That caution is the signal. At the start of 2026, 78% of European Business Association member companies reported a shortage of skilled workers, with welders, CNC operators, maintenance fitters and sewists among the scarcest trades. Defence work competes for the same people, since projected defence-industrial capacity of roughly USD 55 billion for 2026 runs well ahead of funded orders, leaving manufacturers bidding for engineers and operators rather than for equipment. Energy adds a scheduling dimension, with electricity, gas and steam supply 13% lower year on year in the first half of 2026.

Reserved capacity, forecast commitments, scheduling priority and the agreed response to outage days therefore have to be negotiated and priced explicitly. A buyer who assumes these will be conceded later has bought a quotation rather than capacity. How supply then physically reaches the buyer is a separate exercise, addressed in supply chain continuity and logistics.

Transferability is the test that low-capital models usually fail

Contract manufacturing lowers capital exposure while quietly raising operational dependency. The question that exposes the difference is whether production could be moved, if the relationship ended tomorrow, without rebuilding the process from the beginning.

Answering it means establishing who owns the tooling and whether it can be removed, whether documentation is complete enough for a second producer to execute rather than reverse-engineer, whether engineering changes are recorded in the buyer's system or only in the supplier's, and whether critical know-how sits with individuals on the supplier's payroll. Regulated and customer-approved products add a further lock, because approval granted to one site must be earned again at another. Where the specification cannot be written in a form another manufacturer could execute, the buyer has not outsourced production so much as become captive to a single producer. Whether a particular producer meets these requirements is a distinct question of supplier and counterparty verification.

How Transferable Is the Manufacturing Model?


Process characteristic

Transfers readily

Transfers with difficulty

Why it decides the model

Tooling

Buyer-owned, removable, drawing-defined

Supplier-owned, embedded in a bespoke line

Tooling that cannot be lifted turns a supply contract into a dependency

Process definition

Documented parameters and an agreed control plan

Operator craft and undocumented settings

A second producer must be able to execute, not reverse-engineer

Conformity route

Buyer holds the technical file and declaration

Approval granted to the producing site

Site-bound approvals must be re-earned, costing months of requalification

Inputs

Standard, multi-source materials and components

Supplier-controlled or single-source inputs

Input control transfers pricing power to the producer

Engineering support

Change control recorded in the buyer's system

Iteration managed informally by the supplier

Undocumented change accumulates as supplier-held know-how

Volume profile

Repeatable runs above the supplier's economic minimum

Frequent small runs with heavy changeover

Minimum runs and changeover cost, not unit price, set the real floor

Customer approval

Buyer-level or brand-level acceptance

End-customer approval tied to the manufacturing site

Site-linked approval removes the practical option of a second source

Where the arithmetic turns towards owned capacity

Outsourcing stops creating value at identifiable points. It ceases to pay when volume is stable enough that the supplier's margin exceeds the annualised cost of owning the equivalent line, when scheduling priority becomes commercially decisive and cannot be bought, and when the process itself is the competitive advantage and every iteration trains a supplier who also serves others. The same holds where quality variation cannot be closed by inspection, or where no credible second source exists for a product the buyer cannot afford to interrupt.

The model therefore works best when staged. Qualification and a first commercial run test the producer cheaply, a second stage commits volume and builds the control architecture, and a third tests whether it scales. Only then is there enough evidence to decide between remaining outsourced, building owned capacity or, in some cases, acquiring the manufacturing partner. The value of the early stages lies in what they reveal before irreversible capital is committed, which in a wartime economy is worth more than the margin saved.

What is likely to change by 2030, and what is only intended

Four developments will move the balance, and they deserve different weight. Ukraine's parliament adopted legislation in April 2026 harmonising accreditation and technical regulation with EU rules, which is observed fact. The Ministry of Economy expects the conformity assessment agreement covering machinery, low-voltage equipment and electromagnetic compatibility to take effect in 2027, a government expectation rather than an outcome. The National Bank forecasts growth of 1.8% in 2026 and around 2.8% in 2027, supported partly by investment in production capacity, an institutional forecast. Extending carbon border rules to steel-intensive downstream goods from 2028 is still only a proposal.

The direction is convergence. Ukrainian producers will progressively meet European conformity and quality expectations, and wage and compliance costs will rise as they do. Our reading is that the window in which contract manufacturing is the cheapest way to test Ukrainian production is widest now, before convergence removes both the discount and the need for an intermediate step.

The decision is about capital and control rather than unit price

Outsourced production in Ukraine is best understood as the purchase of an option. It substitutes a reversible commercial exposure for an irreversible industrial one, at the price of control over process, schedule and knowledge. Buyers who judge the model on conversion cost alone tend to meet the control problem late, usually when they can no longer move, while those who treat it as a capital-allocation decision, with transferability designed in from the first order, keep the ability to choose again. Once the model is adopted, the management task shifts from sourcing to supplier interface and production oversight. Buyers weighing what Ukrainian suppliers already make are answering the different question set out in sourcing from Ukraine.
